· Week 49 · LatestOverspeed protection checks
Overspeed protection is the one turbine function that has to work the first time it is needed.
Overspeed protection is the one turbine function that has to work the first time it is needed.
How I approach an overspeed protection check:
- 1.Separate from the speed control. Own probes, own logic, own trip path.
- 2.Three channels, voted two out of three. One failed channel gives an alarm, two agree and it trips.
- 3.Overspeed and over-acceleration. The rate trip acts before the level is reached.
- 4.Simulated speed test, one channel at a time. The other two keep protecting the unit.
- 5.De-energise to trip. Remove the power and the fuel shut-off valves close.
- 6.Latched and recorded. No reset until the cause is clear.
What's on your list? Do you prove the full trip path to the valves, or stop at the relay?
· Week 48Safety rules
No permit, no work.
No permit, no work. That is where safety on a turbine job starts.
How I work on every Telic assignment:
- 1.Permit first. No work starts without the site permit, risk assessment and toolbox talk.
- 2.Every source isolated as the job requires. Electrical, fuel gas, liquid fuel, hydraulic, lube oil, air, rotation, heat and fire suppression.
- 3.Isolations by the site. The site's isolation authority isolates and locks. I go through the isolation list before I sign on.
- 4.No change to logic or settings without the client's written approval and a record.
- 5.Enclosure entry only with the site's fire suppression and gas detection inhibit procedure.
- 6.Stop the job. Anyone on site can, any time, no blame.
Where client and Telic rules differ, the strictest applies.
Which part of the permit do you always check twice?
· Week 47DLE mapping explained
A DLE engine runs in a narrow window.
A DLE engine runs in a narrow window. Mapping is how you find it. And there is one per burner mode.
- 1.Three flame rings. Outer A, pilot B, inner C. Only the pilot ring is always fuelled.
- 2.Burner modes. Rings are staged in as power goes up. On an LM6000: B, BC/2, BC, AB, ABC.
- 3.Lean limit. Too cold: CO and unburnt hydrocarbons climb, then flame-out.
- 4.Hot limit. Too hot: NOx climbs and combustion dynamics rise. Whichever comes first sets the edge.
- 5.A window per mode. Each mode has its own window, and it moves with power.
- 6.The schedule. Set inside every window with margin. Bleed walks the engine across it, and at the corner of the window the control stages up.
How do you prepare a unit for mapping? What do you check first?
· Week 46Anti-surge control
Anti-surge control, in plain words.
Anti-surge control, in plain words.
A centrifugal compressor needs a minimum flow. Below it the flow breaks down and reverses. That is surge.
How the control keeps it away:
- 1.Surge line. The left edge of the compressor map. Past it, the machine is unstable.
- 2.Control line. A margin to the right of the surge line. The controller acts here.
- 3.Operating point. Calculated live from suction flow, pressure, temperature and head.
- 4.Recycle valve. Opens at the control line and sends discharge gas back to suction, normally via a cooler.
- 5.Start and stop. Open on start, ramps closed once online, fully open on a stop or trip.
- 6.Surge detected. The valve holds a minimum position until the operator resets it.
What do you check first when you commission anti-surge? Valve stroke time, transmitter ranges, or the map?
· Week 45VSV schedule explained
An LM2500 compressor is built for full speed.
An LM2500 compressor is built for full speed. The variable stator vanes make it work at every other speed.
- 1.Input: gas generator speed (NGG), corrected for inlet temperature (T2). Output: VSV position.
- 2.Of 16 stages, seven rows are variable: the inlet guide vane row plus stages 1 to 6. LM2500+: stage 0 added, 17 stages, eight rows.
- 3.Closed at low corrected speed, opening as speed rises. Off schedule, too open: front stages stall. Too closed: NGG runs high for the power, towards overspeed.
- 4.The gearbox-driven VG pump feeds the actuators through a servo valve.
- 5.Each row's vanes are connected by linkages to an actuation ring. One hydraulic actuator per side moves all rings, via a master lever (LM2500) or torque shaft (LM2500+).
- 6.Position feedback (LVDTs on the LM2500+) is checked against demand.
How do you explain the VSVs to new operators?
· Week 44Loop checks LM
A loop check is not done when the HMI shows a number.
A loop check is not done when the HMI shows a number.
How I approach loop checks on an LM package:
- 1.Start at the sensor, not the terminal. Inject at the field end, so junction box, marshalling and I/O are proven too.
- 2.Tag, range and units the same on the card, in the application and on the HMI.
- 3.Thermocouples: right extension cable and connectors all the way (type K on the LM2500), polarity checked.
- 4.RTD wiring: 3 or 4 wire right through, so lead resistance is compensated.
- 5.Speed and vibration: signal in at the pickup end, conditioner matched to the sensor.
- 6.Alarm and trip: drive every signal through both. Check the action, not only the reading.
What do you check first in a loop check? And what would you add?
· Week 43Load sharing segments
A Woodward easYgen / LS-6 power management system looks complex on the single line.
A Woodward easYgen / LS-6 power management system looks complex on the single line. The logic is simple.
How I explain it:
- 1.Each generator has its own easYgen. It synchronises and closes its own breaker.
- 2.Every other breaker that must synchronise (tie, bus coupler, mains) gets its own LS-6. It measures both sides and closes in sync or onto a dead bus.
- 3.All units talk on one load share bus, CAN or Ethernet.
- 4.Open tie breakers split the busbar into segments. Sets only share load with sets on the same segment.
- 5.kW is shared as an equal percentage of rating, not equal kW. A smaller set carries less.
- 6.kvar is shared the same way, through the voltage regulator.
How do you test the segment logic at commissioning? Breaker by breaker on the live bus, or simulated first?

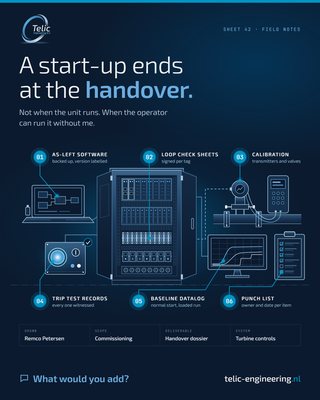

· Week 42Commissioning handover dossier
A start-up is not finished when the unit runs.
A start-up is not finished when the unit runs. It is finished when the operator can run it without me.
What I leave behind at commissioning handover:
- 1.As-left software, backed up, version and date labelled
- 2.Loop check sheets, signed per tag
- 3.Calibration records for transmitters and valves
- 4.Trip test records, every one witnessed
- 5.Baseline datalog of a normal start and a loaded run
- 6.Punch list with owner and date per item, nothing open by word of mouth
And one walk-through at the control cabinet and field instrumentation with the people who stay on site.
What do you want on your desk at handover? What would you add, or ask for first?
